A project schedule is an operating time table of a project. It serves as a basis for monitoring and controlling project activity. However merely having a project schedule in place won’t result into timely completion of a project. As Peter Drucker said,
Plans are only good intentions unless they immediately degenerate into hard work
Peter Drucker
Brian Tracy, author of Eat that Frog!, argues that every minute allocated to planning saves as much as 10 mins in execution.
However, most project managers fall into a trap of over-planning. This leads to the well-known “paralysis by analysis” syndrome.
The primary purpose of planning is to set a direction so that project team knows exactly what must be done, when it must be done, what resources will be required to produce the project outcome and when each resource will be needed.
We naively consider project planning related only to project scheduling. However, according to the PMBOK, various plans are prepared to handle a project, such as the risk management plan, communication management plan, cost plan, quality plan, and stakeholder management plan, to name a few.
In this article we will discuss only on time management aspect of project planning. This is also known as project scheduling. The good project schedule is a outcome of a proper approach to its development. We will look at proven best practices to building an executable project schedule.
A step-by-step schedule development approach consists as
- Developing the work breakdown structure (WBS)
- Defining the work packages
- Defining activities
- Defining logic
- Defining resources and work
- Defining time frame
- Analyzing the schedule
Developing the Work Breakdown Structure (WBS)
Work breakdown structure is hierarchical decomposition of the total scope of work to be carried out by the project team to accomplish the project objectives and create the required deliverables.
An easier way to visualize a WBS is as a tree diagram that lists all the tasks and shows the relationship between those tasks. It is like an organisation chart; each successive level adds more details. The last level of WBS is actionable tasks.
Development is WBS is the backbone of project schedule. There are two types of WBS used within industry.
- Functional WBS
- Deliverable WBS (product)
Functional WBS

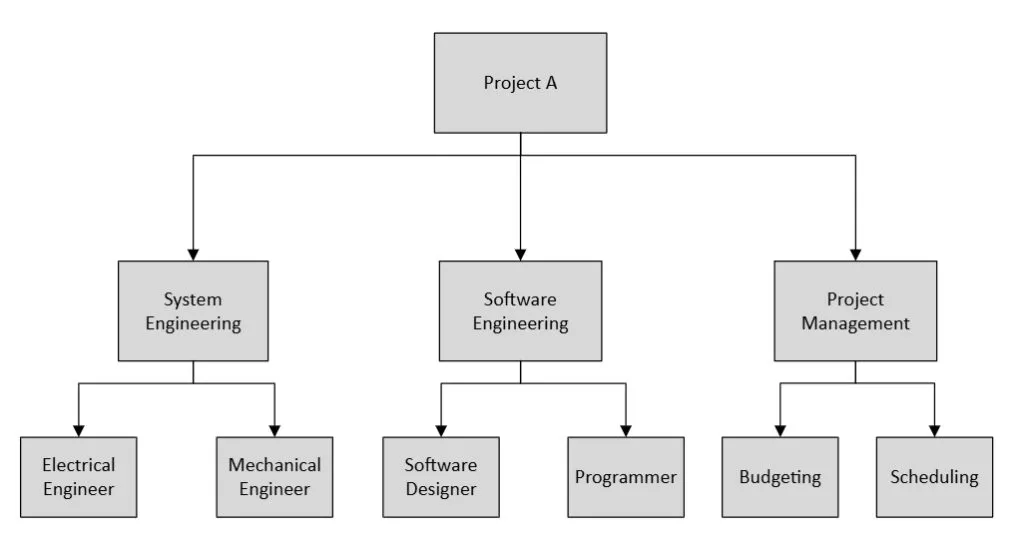

The functional WBS is used in organizations that are heavily involved in the functional aspect of business. Work is broken down as per functions such as Breakdowns such as System Engineering, Software Engineering, and so on. Most often these functions are dependent on each other to perform their tasks. For e.g. some requirements performed by System Engineering are necessary before design work can begin within other engineering groups. Here is a illustration of functional WBS

Deliverable WBS

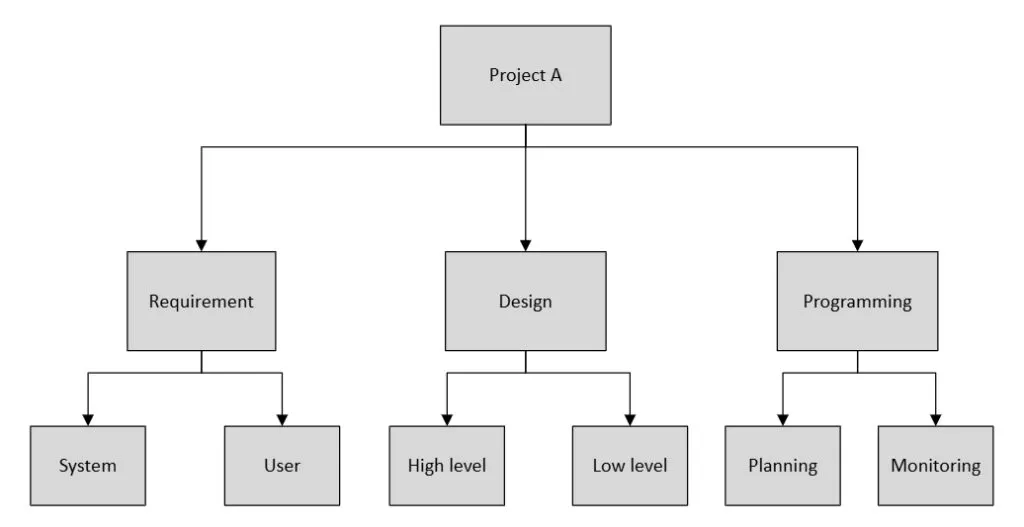

The deliverable oriented WBS provides most control over the project and considered as best practice for WBS development. A deliverable oriented WBS allows breaking down a project into small chunks of clearly defined deliverables. This leads to seamless traceability throughout the whole project, from the lowest level sub assemblies of a product to ultimately a workable assembled product. This ease in traceability ensures that the customer is getting everything as per the requirements. Here is a illustration of deliverable WBS.

Define Work Packages

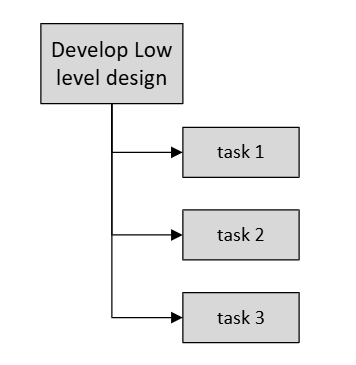

The work package is lowest level of detail within WBS. In above example, low level system design is a work package consisting many different activities which make up a system design. The work package description is key to understanding the work to be accomplished within a constraint of Scope, Quality, Time and Cost.
Work package should be defined in verb-noun structure describing an action to be carried out on the item. For e.g. develop low level design is proper format of defining a work package.
Define Activities
Activities are further breakdown of work packages. These are also called as tasks. This is a work which can be measured and assigned to a cost budget. The activities are actual actions performed by project team members, they can be measured and monitored.
It is imperative that activities must be measurable.

Defining Logic in project schedule
Logic is about setting up the task inter-dependencies in the project schedule. Planning and care must be taken to ensure that the logic is accurate and that false or soft logic is not used. Hard logic is the only valid form of logic to use within a schedule; any false or soft logic defeats the effectiveness of the tools used and will need to be modified during schedule execution.
Every activity in the schedule will have at least one predecessor and one successor. The only exception to this is the very first activity (contract award, project start, or whatever you call it), which will not have a predecessor, and the very last activity (contract complete, project end …), which will not have a successor. If the activities don’t have predecessor or successor, these won’t show up in the project’s critical path leading to incorrect schedule analysis.
False logic is used to arbitrary modify the sequence of activities in a schedule. This must be avoided
Hard logic is used which provides valid links between activities.
There are four standard types of logic used in project schedule:
- Finish to start
- finish to finish
- start to start
- start to finish
Finish to Start dependency
The Finish-to-Start (FS) logic type simply states that the succeeding activity cannot begin until the preceding activity has completed. An example of the FS constraint is that the foundation of a house must be finished before the walls can be built. This is most popular logic types you will find in a project schedule.

Finish to Finish dependency
The Finish-to-Finish (FF) logic type, is used to identify that a successor activity cannot finish until the predecessor activity is finish. This is normally used when both activities can be performed for the most part in parallel; however predecessor activity must be finished before a successor activity is finished.

An example of the FF logic is that a document cannot be finalized until all comments have been received and incorporated. The predecessor in this case is the comment period with the successor being the incorporation of comments and finalization of a document. This indicates that once some comments have been received, work can begin incorporating to those comments but the document is not complete until all comments are received and handled.
Start to Start dependency
The Start-to-Start (SS) logic type is used to signify that for a succeeding activity to begin, a preceding activity must first begin. This is normally accomplished when both activities can be performed for the most part in parallel; however some work must begin before work can begin on the other activity.

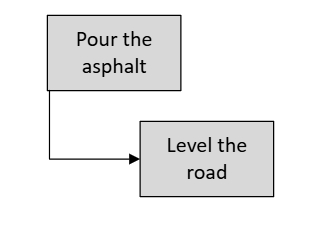

For example, in a construction project, pouring the asphalt and leveling the road can have a start-to-start dependency. In order to start leveling the road, the asphalt must first be poured.

Start to Finish dependency
The Start-to-Finish (SF) logic type is usedveryrarely. The SF logic is not intuitive, but it is defined as the successor activity must start before the predecessor activity can finish.
Think about how you would implement a new system and turn an old system off. You can complete (i.e., turn off) the old system as soon as the new system has started in production—but not before that.

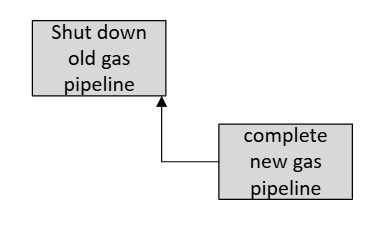

Say you’re building a new gas pipeline. You would first finish construction and implementation of the new pipeline before you would begin shutting down the old pipeline.

Defining Resources in project schedule
Definition of resources is a multistep process. Ensure that these steps are followed to provide for the most executable schedule.
Define the resource type
You must ensure that you identify the type of resources required to accomplish the activity. Do you have right expertise assigned? There are assumptions made while assigning the resources, how valid are those assumptions? For instance, when identifying a programmer, you assume that they have the computer and tools required when placed on your project, therefore the computer and tools are not identified as additional resources. But what if the organization requires to lease or rent the computer and tools, and they are not available when the resources are on-boarded onto a project. Now you have a programmer, but nothing they can work with.
Ensure that you identify those resources that are consumable, renewable, labor, and non labor.
Define the amount of work for each resource
For all resources, you will need to define the amount of work required. Again, ignore the quantity of resources at this time, only the amount of work which needs to be accomplished. For instance the activity may require 40 hours of work to accomplish something, but that could be one person for one week, or five people for one day as well as many other combinations. However, at this point, you are just identifying the amount of work to accomplish, and not the number of resources required to accomplish the work.
Define Durations in project schedule
The last step in building your schedule is to define the durations of the activities. This will enable you to determine how many of each type of resource are required as well as the time it will take to complete the project.
Resource efficiency factor
Unless you are in truly project oriented organisation, you can not assume resource is available 100% of the time. I always plan resources at only about 75% availability. This means I plan 6 hours of work for every 8 hours I need. This is very pragmatic way of scheduling because resources are pulled away from work to attend the meetings, answer calls, or they may be involved in other cross functional activities. Planning in this manner will produce more executable schedule.
Three point estimates
Most of the time, when you prepare a schedule, you assign single point for your duration. Many studies have shown that a single duration schedule will be executed on time and on budget only approximately 50% of the time. Therefor it is advisable to produce three point estimate on activity durations. This gives you couple of advantages.
- Three point estimates by performing a simple PERT(Program Evaluation and Review Technique) calculation increases the project execution plan up to 73% based on empirical information.
PERT estimate = (Optimistic + 4* most likely+ Pessimistic)/6 - Three point estimates are required in order to perform a proper risk management analysis of the schedule as well as running Monte Carlo simulation against the schedule.
Analyzing the project schedule
There are many methods used to analyze the schedule, but the critical path method is by far the most dominant method and is the best understood, hence is widely used in the industry.
The project critical path is the sequence of activities that defines the longest path and shortest duration calculated for the project. The critical path determines the duration of a project.
Practice standard for Scheduling, third edition
We must analyze the schedule to ensure that proposed critical path actually is actually making sense from execution perspective. Does it line up with the thinking of project stakeholders that this is really the critical path in a schedule? There may be fine tuning of resources required, the duration, or even the logic, as we go through the analysis of the critical path.
There are other aspects to the path which must be analyzed to ensure an accurate planning schedule is developed. Associated with the critical path are the near critical path and the risk path, as discussed below.
Near Critical Path
While the critical path is the longest path through the schedule, attention needs to be given for any task that may become critical in near future. These are viewed as items with a certain amount of total slack. As a general rule of thumb near critical activities would be those that have less slack than half of the reporting period. In other words, if you are planning to report status on your project in a biweekly fashion (10 days), then the near critical path would be defined as any path with less than 5 days of slack. Of course, this number will vary according to the project.
Risk Path
Risk path is different way of looking at the schedule. The risk path is viewed as the riskiest path through the schedule. In a schedule, if many activities are dependent on a specific activity, then that specific activity is the most riskiest. Since if the risk activity is delayed, all the succeeding activities may likely to get delayed as well.
If you are interested in understanding more on project risk management, you can refer to my blog on Risk Management.

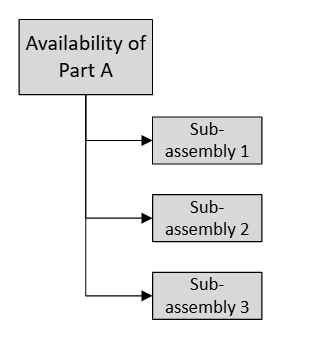

For e.g. if part A is required in all the sub-assemblies, then availability of part A is the risky activity. If part A did not come in time, all the downstream activities won’t get started. Hence the entire network path will prone to high risk of getting delayed.

Summary
Developing a project schedule involves several key steps. It starts with preparing a WBS, defining the activities, checking their dependencies on each other, assigning the resources and duration to these activities and finally analyzing them for critical path
WBS is as a tree diagram that lists all the tasks and shows the relationship between those tasks. Logic plays a very important role in schedule development. Logic defines the dependency among the activities in a project schedule. There are four types of logical dependencies.
Once the logic is defined, we can define the resources and assign the time estimates to the activities. Three point estimate is more accurate than single point estimate. After activity duration and resources are assigned to the schedule, we must analyze it for the critical path. It is always recommended that critical path shown in a schedule is reviewed by the stakeholders for its correctness and practicality.
Its your turn
Now you have learned how to prepare a project schedule. Can you prepare a simple project schedule for your project? Please share your experience in the comments section – How did you start scheduling? What were the challenges you face? Did you analyze the critical path and what were your findings?
References
Here are the further resources if you want to go deep in the topic:
- Practice standard for scheduling, Third edition
- Project Management QuickStart Guide, Chris Croft
