Unraveling the Mysteries of Task types in Project Schedules

Have you ever wondered how the task duration is calculated in Project schedules? It all boils down to simple duration equation.

In this article, I’ll help you understand Project Task Types. Understanding Fixed Units, Fixed Work, and Fixed Duration – can be crucial for managing your project effectively.

These Task Types determine how project scheduling behaves when you make changes to the Duration, Work, or Units values tasks. Let’s break down each Task Type and when to use them.

In the background, scheduling engines such as Microsoft Project uses a simple duration equation to calculate the task duration.

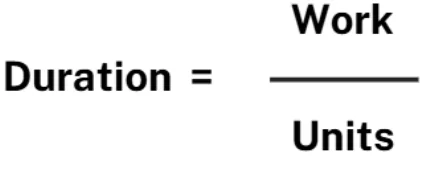

duration equation
Duration Equation

Units represent percentage assignment of Resource. In most scheduling engines 1 Unit is equivalent to:
1 Unit = 100% = 8 hours 0.5 Unit = 50% = 4 Hours

The Microsoft Project Task Types feature allows you to fix or “lock” one of three variables in the Duration Equation: Units, Work, or Duration.

task type
Task Type

The Microsoft Project Task Types feature allows you to fix or “lock” one of three variables in the Duration Equation: Units, Work, or Duration.

This locking ensures that when you change one variable, Microsoft Project recalculates another value accordingly, maintaining consistency in your project plan.

This leads to three task types:

  • Fixed Units
  • Fixed Duration
  • Fixed Work

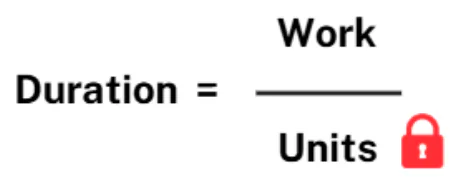

The Units value is locked. When you change the Work, Microsoft Project recalculates Duration.

duration equation
Duration equation: Fixed Units Task

task 1 is Fixed Units.

fixed units task - example
Fixed Units Task – Example

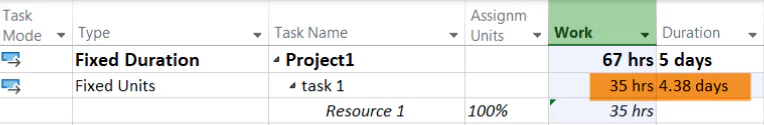

Task 1 work is changed from 24 hrs to 35 hrs. Task Duration changes without changing the units value.

fixed units task - example
Fixed Units task – Example

Similarly, when you change the Duration, Microsoft Project recalculates Work.

Use Fixed Units Tasks when the availability of a resource is limited, such as part-time resources.

You can also use Fixed Units when you have highly skilled resources working on your project. For e.g. Machine Learning Engineer. You want his availability to be fixed on your project.

When you set Fixed Units, Microsoft Project locks the Units value, but you can freely adjust Work or Duration.

The Duration value is locked. When you change the Units, Microsoft Project recalculates Work.

fixed duration task
Fixed Duration Task

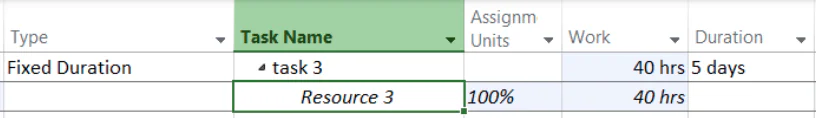

Task 3 is Fixed Duration

fixed duration task -example
Fixed Duration Task – Example

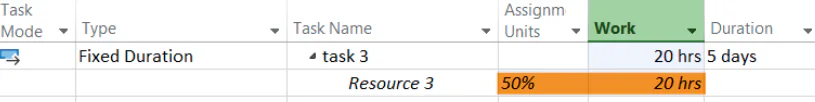

task 3 Units are changed from 100% to 50%. Task Work changes without changing the Duration value

fixed duration task -example
Fixed Duration Task – Example

Similarly, when you change Work, Microsoft Project recalculates Units.

Use Fixed Duration Tasks when a task must be completed within a specific time window.

For e.g. delivering a training program. If training program is for 2 days, you can use Fixed Duration task type.

Some testing activities can also modeled as Fixed Duration activities. For e.g. server must be tested for 30 days to check its various performance parameters before making it available into production environment.

The Work value is locked. When you change the Duration, Microsoft Project recalculates Units.

fixed duration task
Fixed Work Task

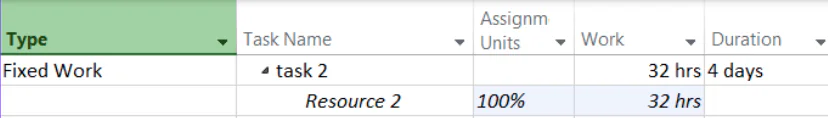

Task 2 is Fixed Work

Fixed Work Task - example
Fixed Work Task – example

task 2 Duration is changed from 4 days to 6 days. Task Units changes without changing the Work value.

Fixed Work Task - example
Fixed Work Task – Example (New units value is shown in Peak Column)

Similarly, when you change Units, Microsoft Project recalculates Duration.

Use Fixed Work tasks where the amount of Work is fixed, often due to contractual obligations.

For e.g. if you hire a consultant on your project, who will work for 40 hours. You can use Fixed work tasks, because contractually consultant suppose to work for 40 hours – not for 38 hours or 42 hours.

You can also use fixed work tasks when you hire a machine such as high performance computer to run a simulation. In this case you will hire a machine for fixed number of hours for your project.

Understanding Task Types empowers you to make informed decisions about scheduling and resource management in your projects. Whether you’re dealing with part-time resources, fixed contracts, or strict deadlines, choosing the right Task Type ensures your project stays on track.

Check out my 18 Hours LIVE Online Course on Microsoft Projects.

Did you know that nearly 60% of Project Management roles posted on LinkedIn require Microsoft Projects skills?

Microsoft Projects, a project management software in use since 1984, stands out as the most established and widely utilized tool across various industries.

Major players like Fortune 500 companies rely on this software to propel their projects forward. Stay ahead of the curve. Acquire this valuable skill now and set yourself apart from other project managers.
